WorkStudio Help
TimeLine

Build a Structured TimeLine Schedule

Create a structured Gantt schedule with WBS phases, calendars, exceptions, links, milestones, display bands, and phase focus.

Use this walkthrough when you want to move beyond a simple list of tasks and build a structured TimeLine schedule.

The steps use the existing TimeLine screenshots as a practical checklist: start from the default file, define calendars and exceptions, add WBS phases, link tasks, add milestones, review display settings, and focus on one phase.

Related: Create a New TimeLine, Calendars, Calendar Exceptions, WBS and Summary Rows, Dependencies and Predecessors.

Open TimeLine ↗

Start from a new TimeLine

Open a new TimeLine file. Confirm that the main schedule sheet has the planning columns on the left and the Gantt chart column on the right.

New TimeLine file with default planning columns and an empty Gantt chart.

Open the full planning columns

Open the grouped columns when you need fields such as End Date, Productivity, Quantity, Description, Priority, Documents, and People.

New TimeLine file showing all Gantt-related columns expanded.

Review the calendar rules

Open the Calendars sheet. Check the weekday hour columns and make sure blank days represent non-working days for that calendar.

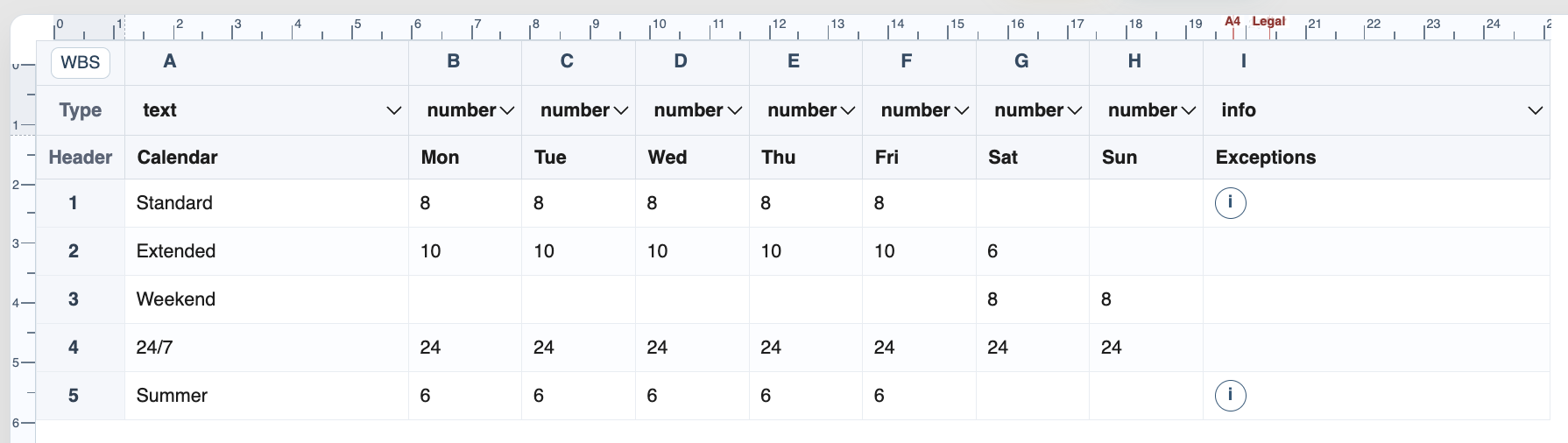

Calendars sheet with Standard, Extended, Weekend, 24/7, and Summer calendars.

Review the exception groups

Open the Calendar Exceptions sheet. Add public holidays, short days, or date intervals and group them with WBS rows when useful.

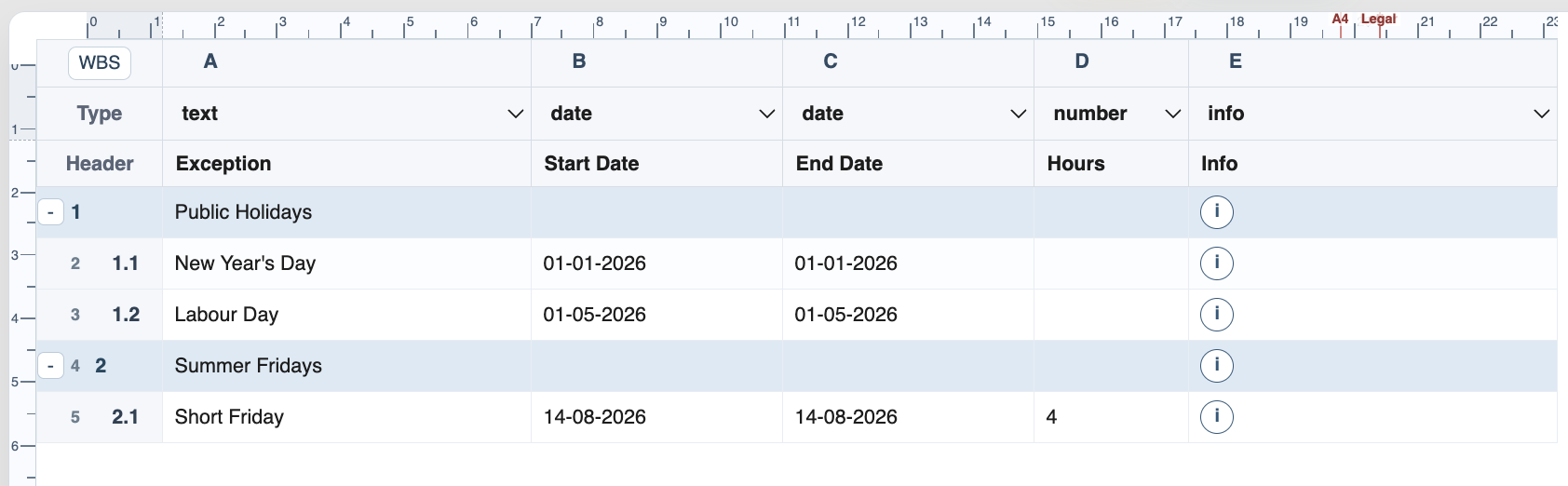

Calendar Exceptions sheet with Public Holidays and Summer Fridays groups.

Create WBS phases

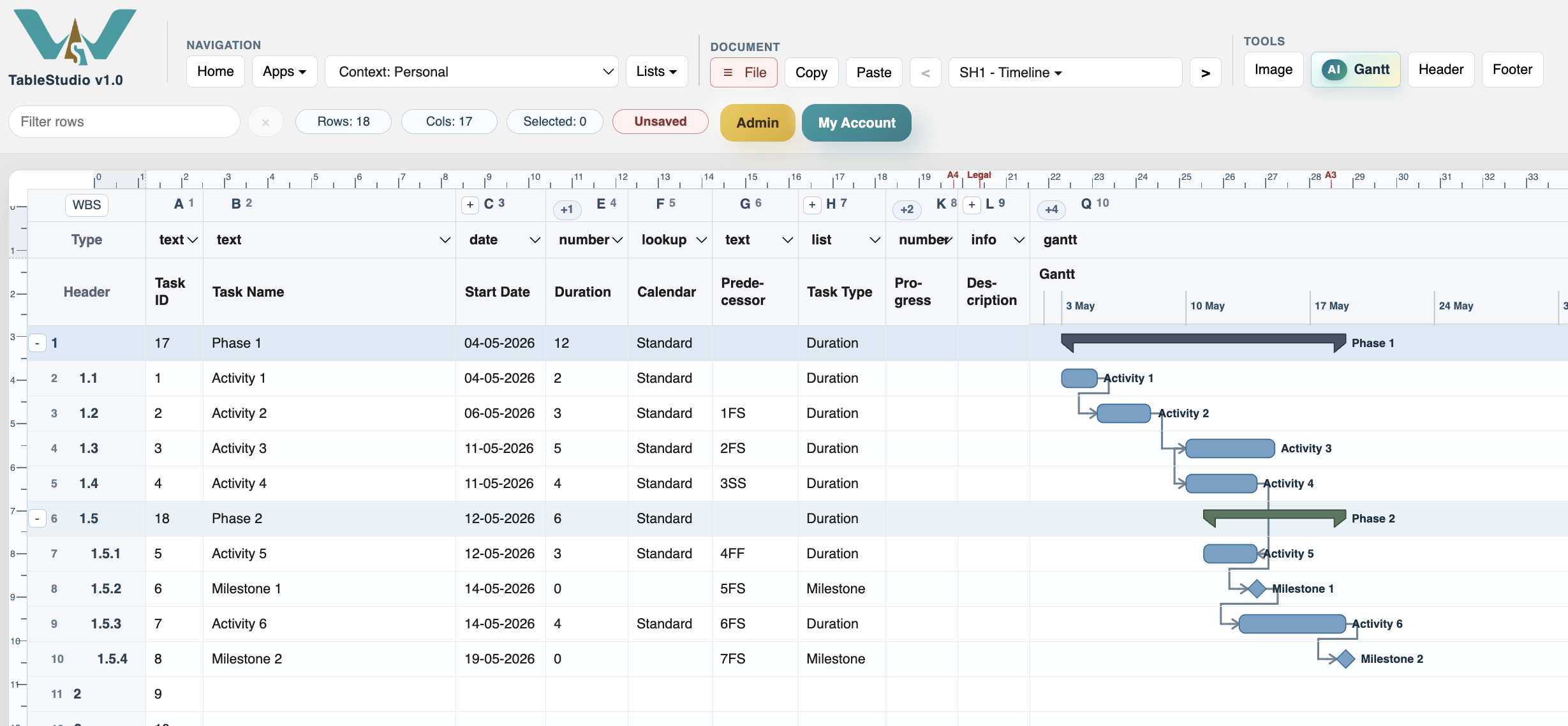

Create phase rows and child task rows. Summary bars are drawn for the phases and roll up from the child tasks below them.

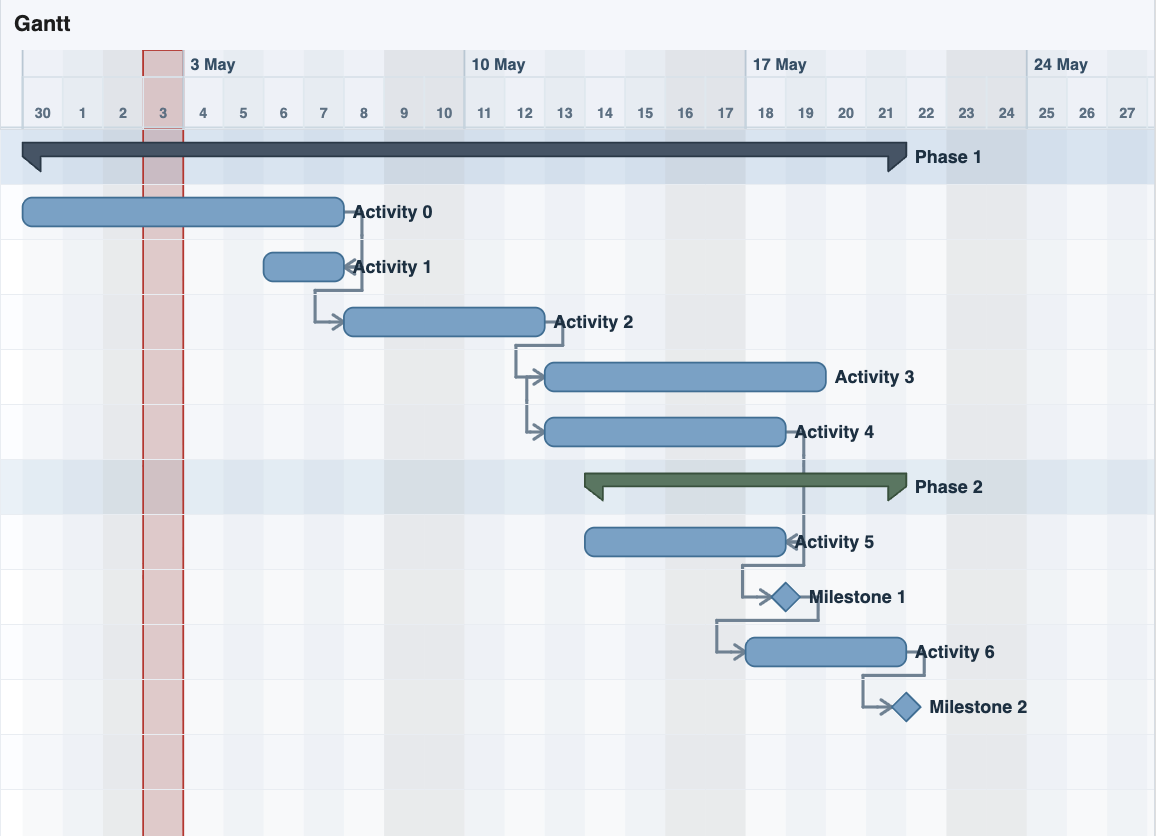

TimeLine schedule with WBS phases, child tasks, links, and milestones.

Link the work

Use typed predecessors or mouse links. The Predecessor column stores values such as 1FS, 3SS, and 4FF.

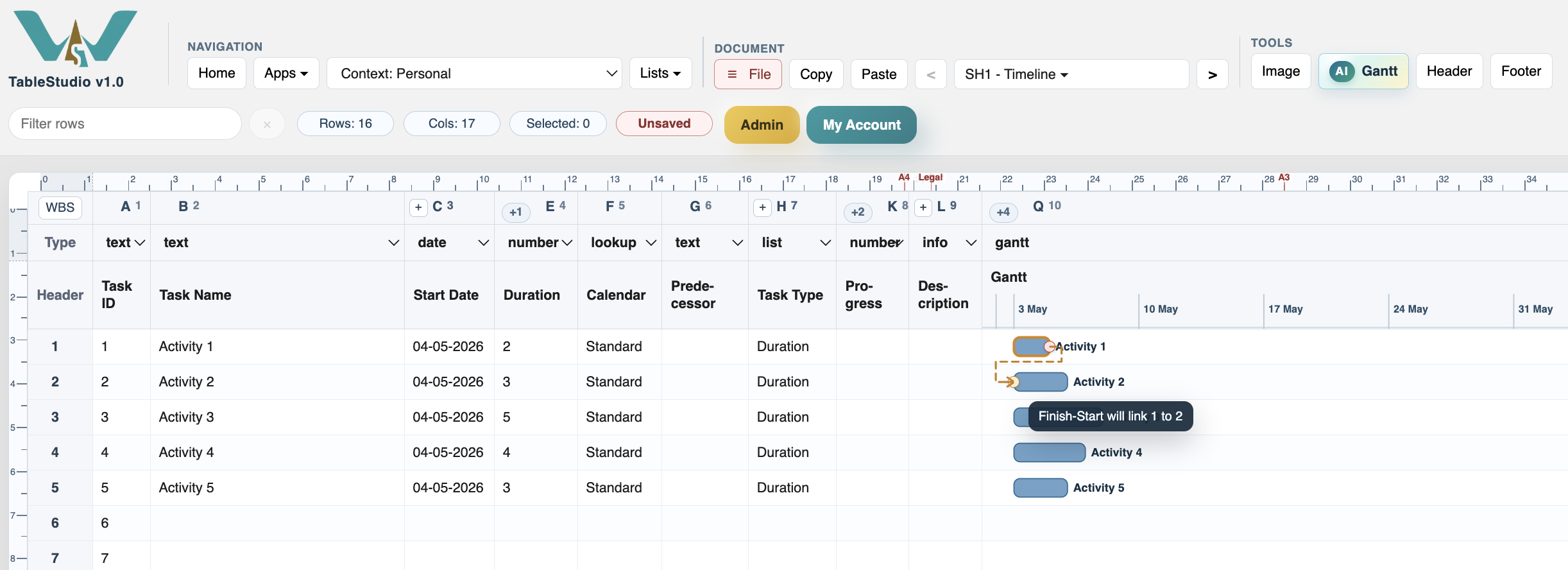

TimeLine showing a mouse-link preview between two tasks.

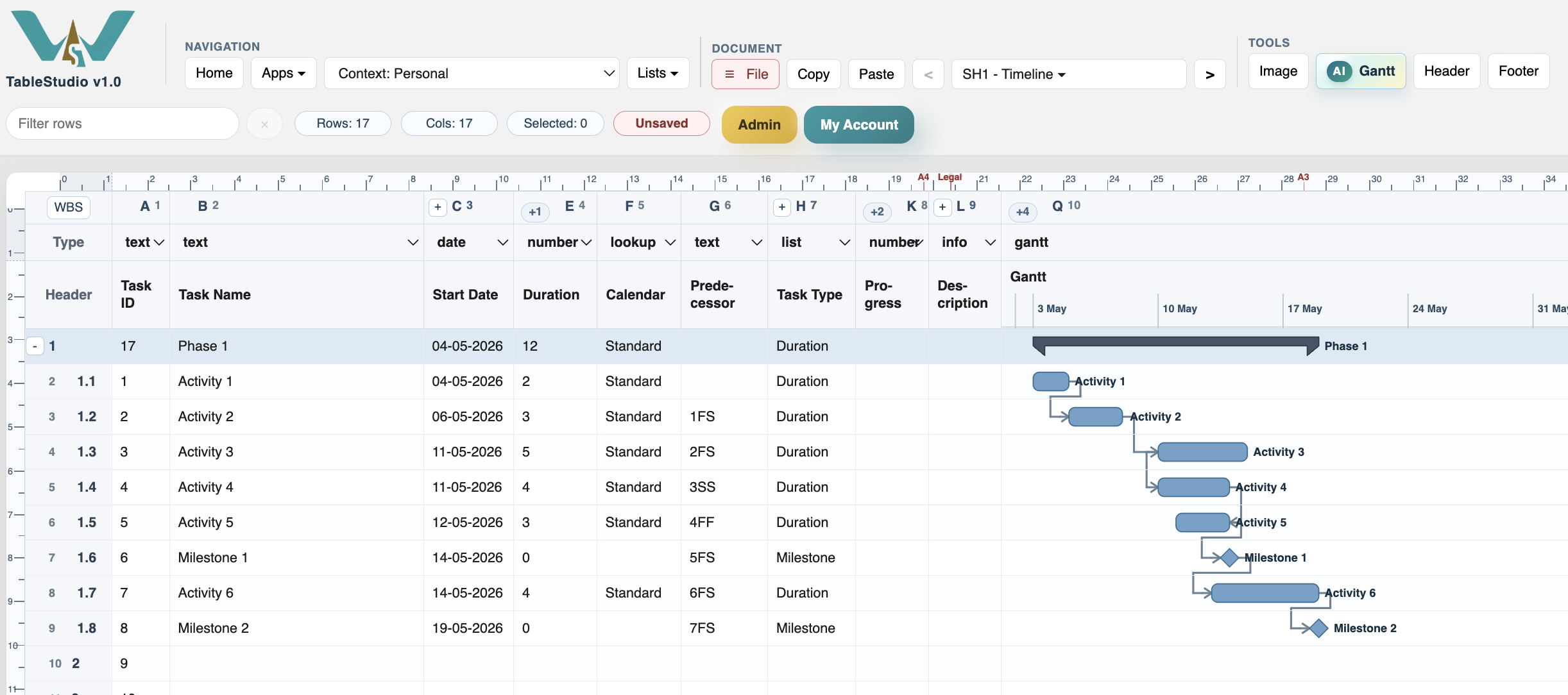

Add milestone rows

Use milestone rows for approvals, phase gates, handovers, or fixed events. Milestones should normally use duration 0 and appear as diamonds.

TimeLine schedule showing milestone diamonds linked to tasks.

Review the chart display

Turn on day bands, weekend display, or current-day display when they help review the schedule. Keep them off when they make dense charts too heavy.

TimeLine chart showing day bands, weekends, and a red current-day marker.

Focus one phase when the schedule grows

Use Focus Phase from the context menu to work inside one WBS branch, then use Show Full Gantt to return to the complete schedule.

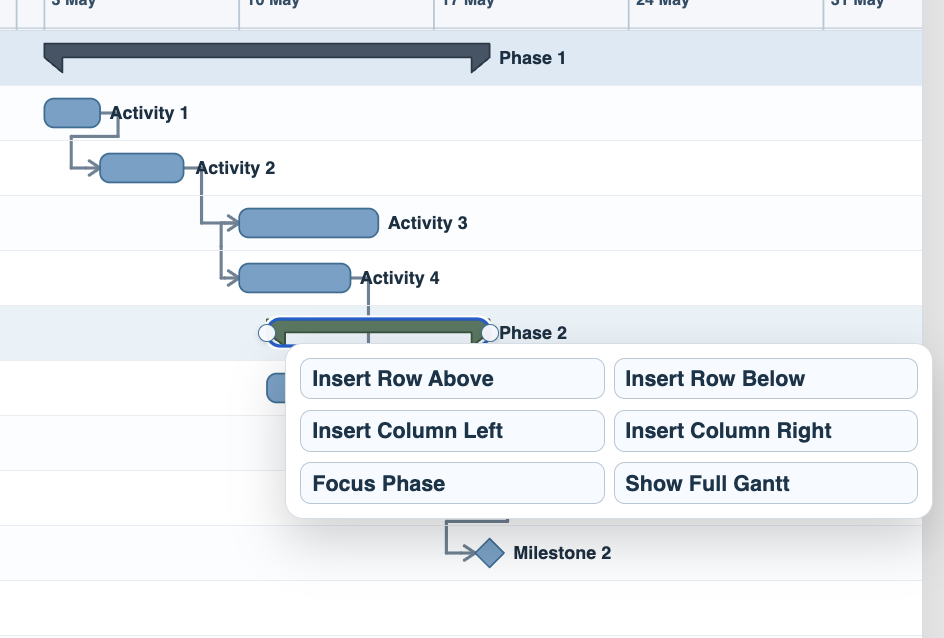

TimeLine context menu showing Focus Phase and Show Full Gantt.

Check the focused phase

In focused view, review only the selected branch and add new rows inside that phase context.

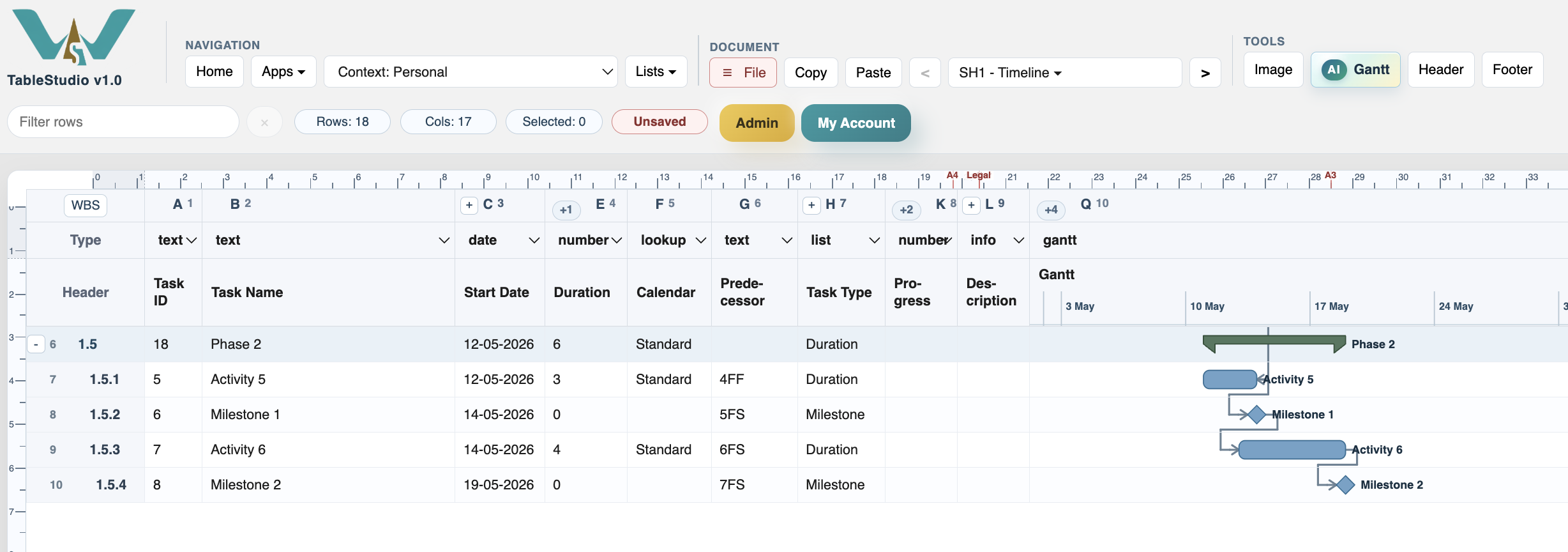

TimeLine focused phase view.
