WorkStudio Help
TimeLine

Use Calendars and Exceptions in TimeLine

Compare three short tasks and see how calendars and the 1 May Labour Day exception change the finish date.

Use this tutorial when you want to understand how TimeLine combines working calendars with calendar exceptions.

The steps below follow the same three-day task starting on 29-04-2026, then move through the TimeLine, Calendars, and Calendar Exceptions sheets so you can compare the resulting finish dates.

This example uses 01-05-2026 as the Labour Day exception in the Public Holidays group.

Related: TimeLine, Create a Simple 5-Task Gantt in TimeLine, TableStudio.

Open TimeLine ↗

Set the three tasks

Create Standard Crew, Extended Crew, and 24/7 Crew. Give each task the same Start Date 29-04-2026 and Duration 3 so the comparison stays consistent.

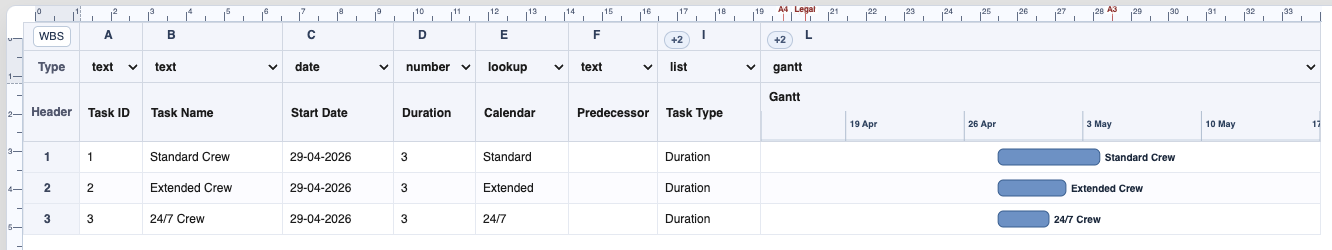

TimeLine with three short tasks that share the same start date and duration, ready for a calendar comparison.

Pick the calendar

Use the Calendar column on each row. Open the lookup and assign Standard to the first task, Extended to the second, and 24/7 to the third.

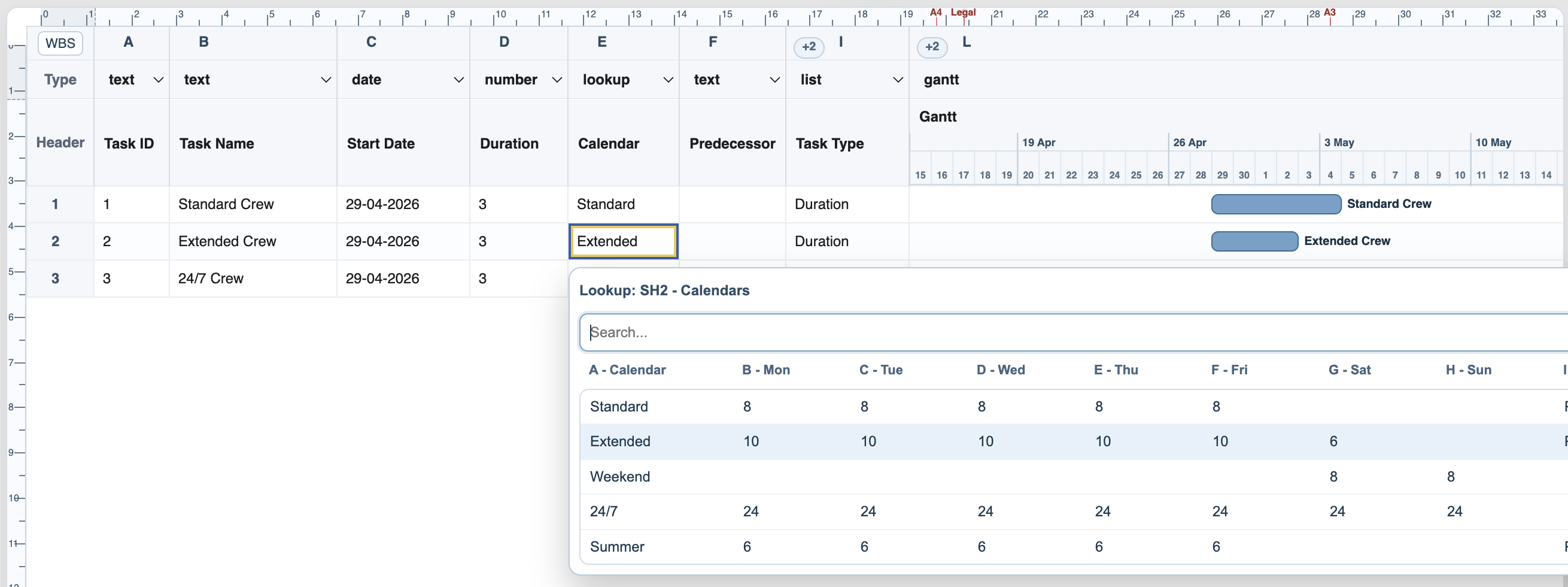

TimeLine with the calendar picker open in the Calendar column.

Open the Calendars sheet

Use the worksheet switcher to move from SH1 - TimeLine to SH2 - Calendars.

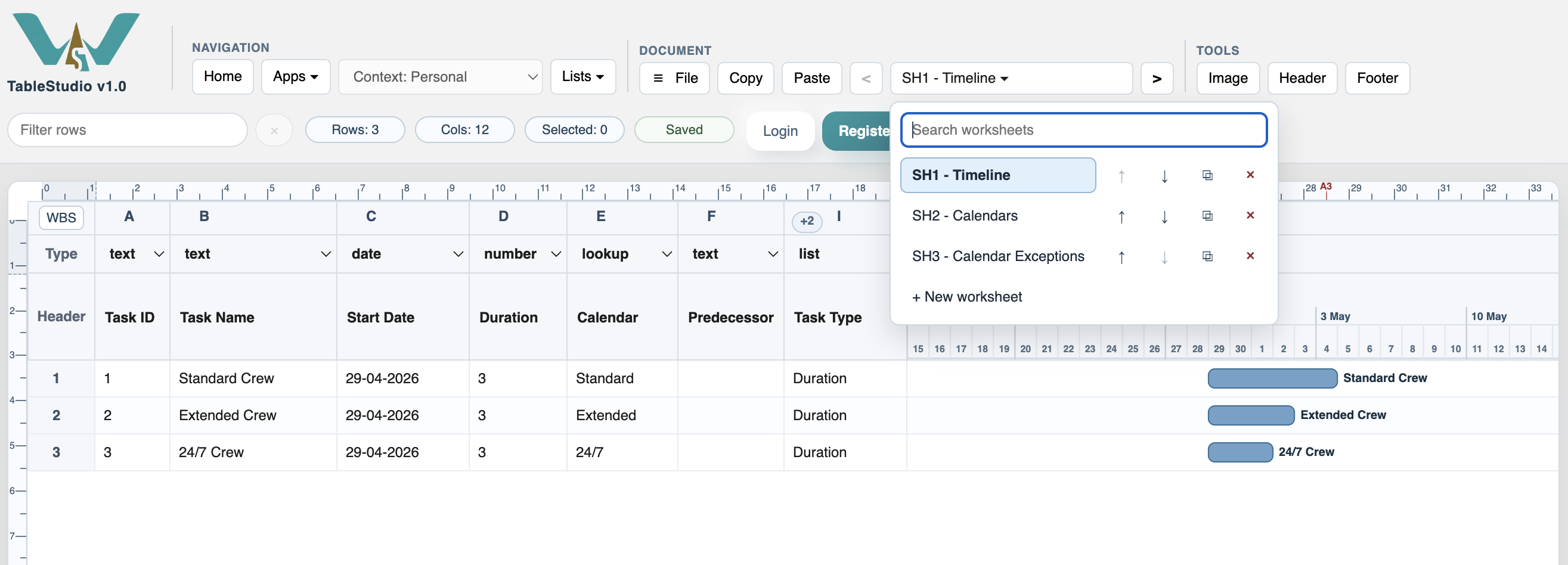

The worksheet switcher open in TableStudio, showing the TimeLine, Calendars, and Calendar Exceptions sheets.

Review the calendar rules

On Calendars, confirm that both Standard and Extended use Public Holidays in the Exceptions column, while 24/7 has no exception group.

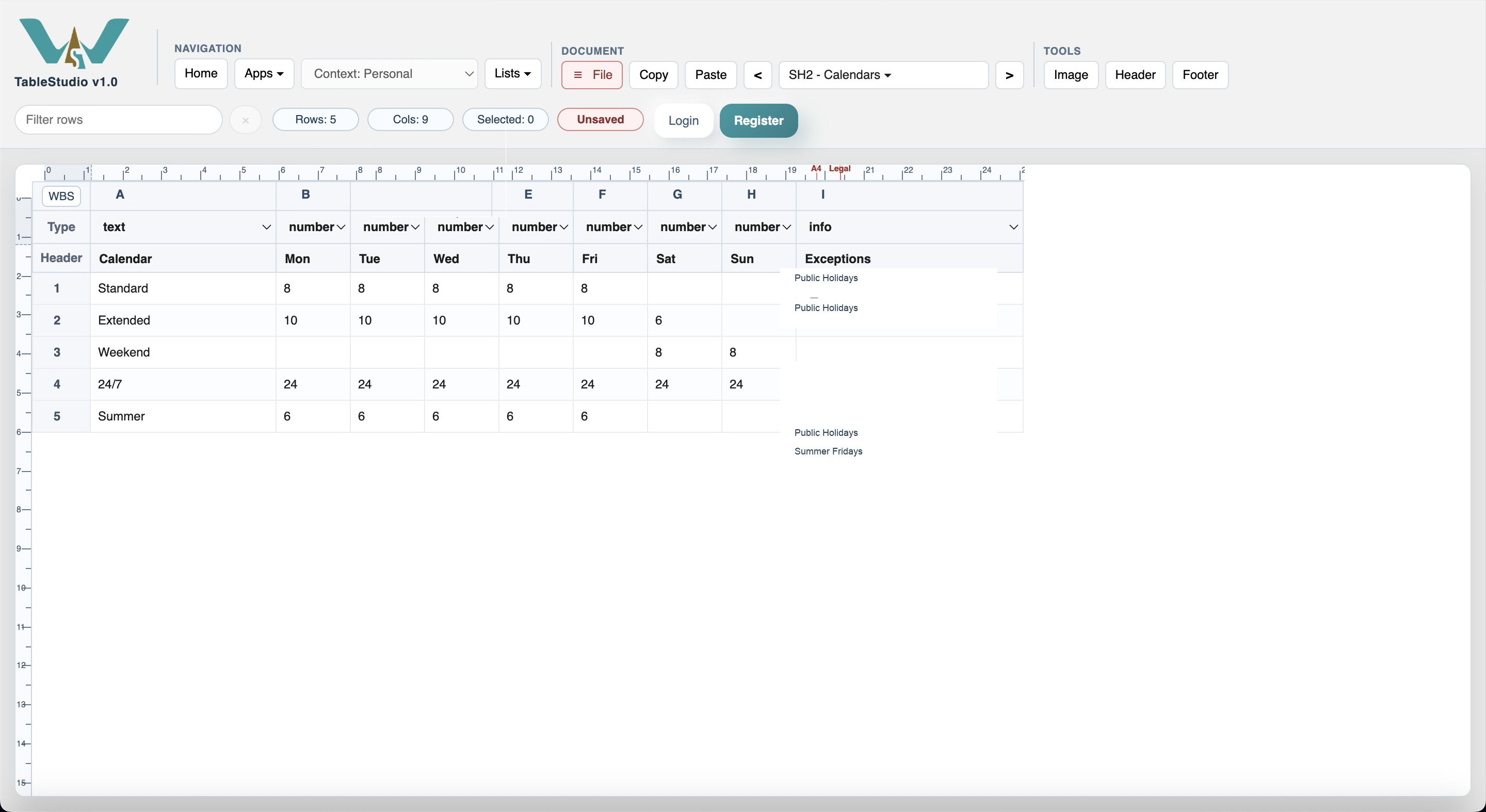

The Calendars sheet showing the Standard, Extended, and 24/7 calendar definitions.

Check the Labour Day exception

Open SH3 - Calendar Exceptions and confirm that Labour Day is set on 01-05-2026 inside the Public Holidays group.

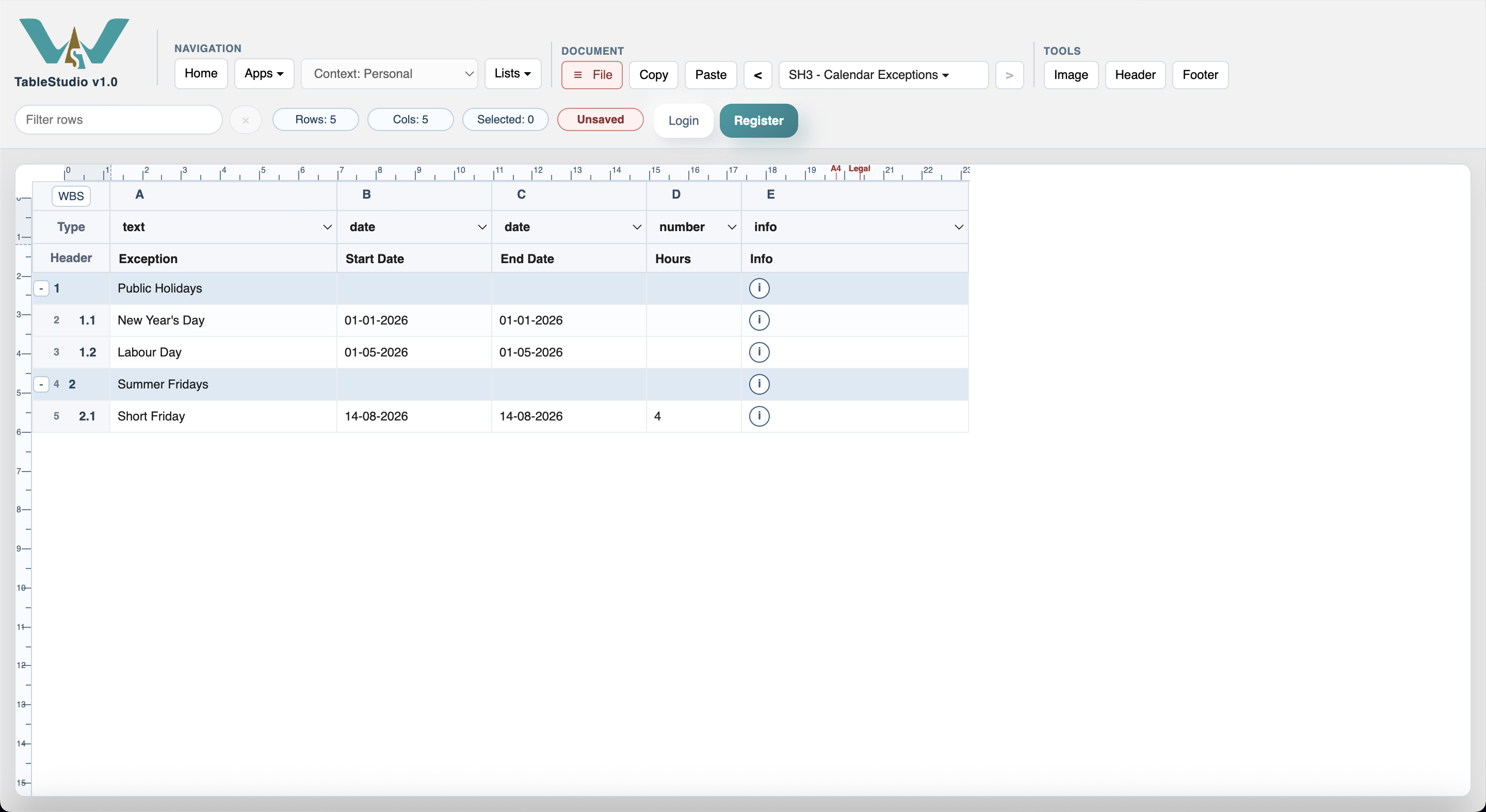

The Calendar Exceptions sheet showing Labour Day on 1 May 2026 inside the Public Holidays group.

Compare the finish dates

Return to TimeLine and compare the result. Standard Crew finishes on 04-05-2026, Extended Crew finishes on 02-05-2026, and 24/7 Crew finishes on 01-05-2026. The difference comes from the assigned calendar and the 01-05-2026 Labour Day exception.

TimeLine showing different finish dates for the same task duration under Standard, Extended, and 24/7 calendars.
