Create a Breakdown from Resources
Create a Breakdown from Resources with a fictional company example.
A Breakdown is a unit-cost recipe. It links to resource records and can also contain another Breakdown. Its unit describes the output; component units describe what is consumed. Our floor recipe produces 1 m2 and consumes 1.05 m2 of panels, 0.40 h of labour, 0.10 h of cutter time and 1 unit of the delivery allocation. At ASTER-26 prices its direct unit rate is 32.40 EUR/m2.
Incidence means component units per output unit. Productivity is the reciprocal: 0.40 h/m2 equals 2.5 m2/h. No. Resources multiplies consumption for a crew; it does not change elapsed crew productivity. A Driving Resource identifies the row used for the displayed Breakdown productivity.
Project / Price Set Code on a Breakdown identifies its recipe set. It is separate from a Resource Price Set. Versions preserve exact assignments: a BOQ points to a specific Breakdown record. Changing the preferred code does not silently replace an assigned revision. Use Versions > New Version to review a changed recipe before reassigning it.
All companies, prices, quantities, dates and documents are fictional examples. They demonstrate the software, not real offers, project evidence or commercial advice.
Create a Breakdown from Resources
Follow the on-screen click instructions and highlighted controls. Field entry moves more quickly; pause or use chapters whenever needed. All companies, prices, quantities, dates and documents are fictional examples. They demonstrate the software, not real offers, project evidence or commercial advice.
Create the recipe
Select New Record > Breakdown. Enter Install floor panels, BRK.01, output unit m2 and currency EUR.
Select the recipe price set
In Breakdown Version enter Project / Price Set Code ASTER-26. Keep Revision 1 and Draft while preparing the teaching example.
Assign the material
In Resources and Components, add a Resource and select MAT.01 Floor panels. Enter incidence 1.05. Confirm the selected resource rate is 18 EUR/m2.
Add labour and equipment
Add LAB.01 with incidence 0.40 and No. Resources 1; optionally mark it Driving Resource. Add EQP.01 with incidence 0.10.
Include delivery once
Add TRN.01 with incidence 1. The material offer excludes delivery. If using a delivered material rate, remove this extra transport contribution.
Check and save

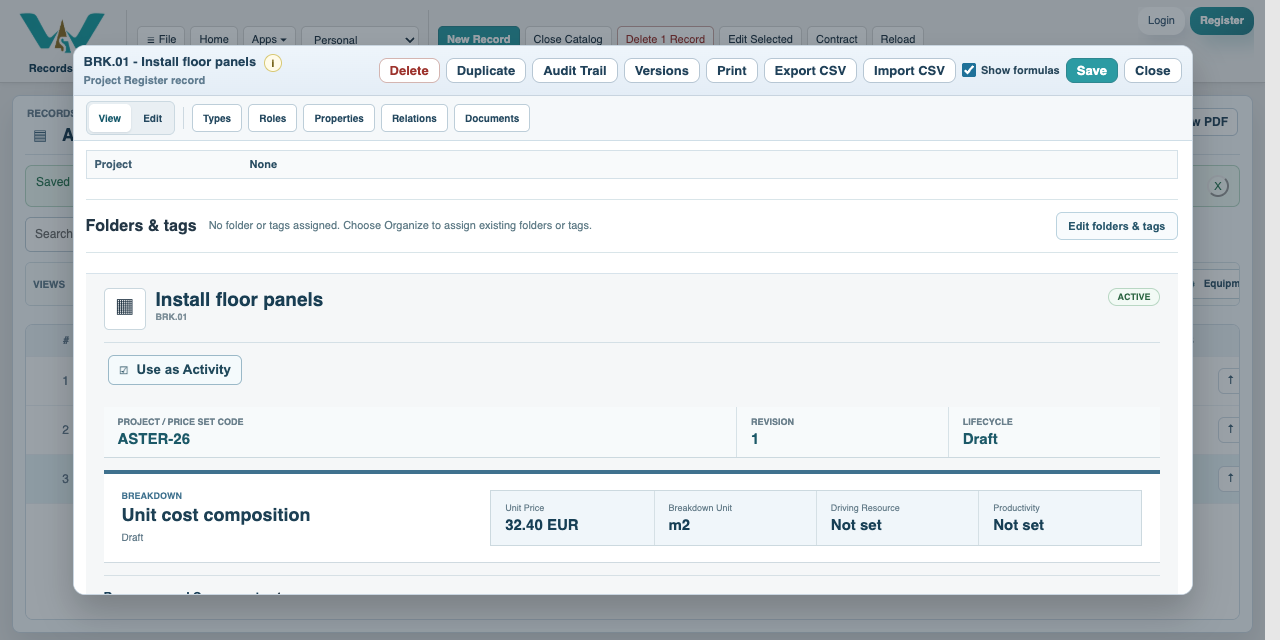

Review 18.90 + 10.00 + 1.50 + 2.00 = 32.40 EUR/m2. Save the Breakdown and later assign it to a BOQ item.

Enable JavaScript to use reading progress and usefulness ratings.
